Downtime Is a Design Choice You Made at Purchase

Ask how long a farm can run without circulation and you get an honest number: for NFT, minutes in full sun. That number sets the value of every spare part on the shelf, and most farms only discover it once. A pump seal that costs a fraction of a percent of project value will destroy a crop worth a hundred times more if it is three weeks away.

This guide gives you a practical way to rank parts by criticality, set stock levels from lead times rather than from gut feel, build an annual shutdown calendar, and budget spares as a percentage of capital that survives contact with your finance team.

Rank by Criticality, Then by Lead Time

TierDefinitionStock policyExample parts
Tier 1 — Crop-criticalFailure stops irrigation within hoursOn the shelf, alwaysCirculation pump (or seal and bearing kit), blower, dosing pump, controller, main solenoid valve
Tier 2 — Production-criticalFailure degrades control or uniformity within daysOn the shelfpH and EC probes, DO cap, pressure sensors, flow meters, UV lamp and quartz sleeve, filter elements
Tier 3 — Comfort and efficiencyFailure raises labour or energy costOne spare per siteScreen motor, vent motor, small fans, lighting driver, solenoid coils
Tier 4 — Structural and long-leadFailure is visible but not urgentOrder on need, keep drawingsGlazing panels, gutter sections, racking beams, custom manifolds

Criticality is only half the equation. Multiply it by lead time: a Tier 2 part with a twelve-week lead deserves on-shelf stock, while a Tier 1 part available from a local distributor in two days may only need a documented supplier commitment. Build the table for your own site — import lead times and local availability differ enormously by region.

Core Spares List by Subsystem

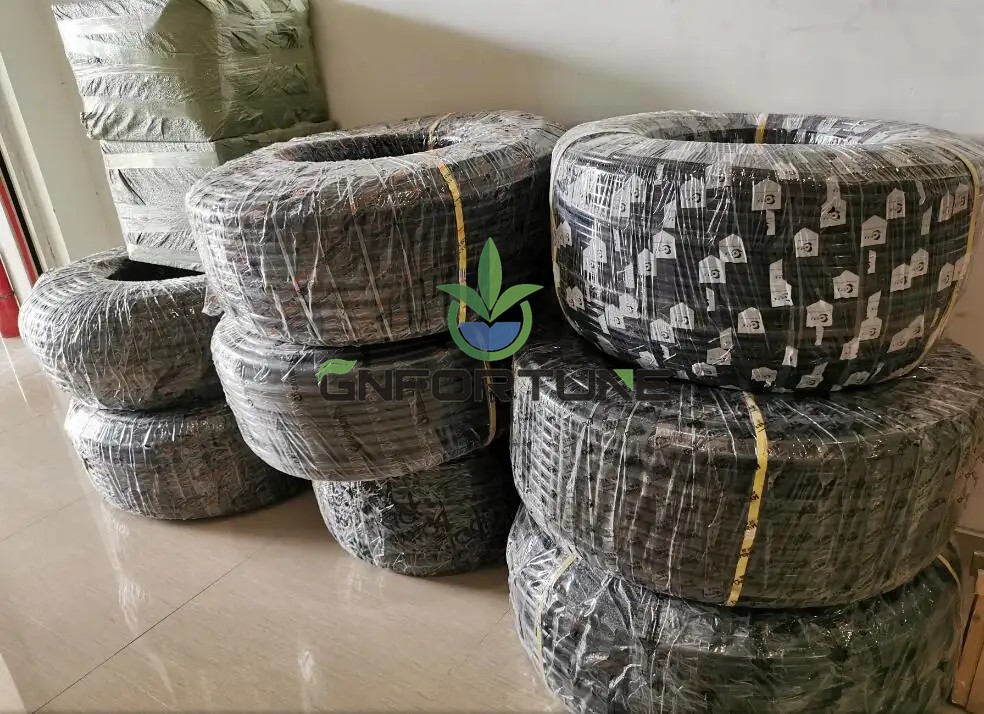

Bundled coils of drip pipe held as spare stock at a hydroponic farm
SubsystemKeep in stockQuantity guide (per 1 ha)
CirculationPump seal kit, bearing set, impeller, gasket set, coupling, spare pump or motorOne full seal and bearing kit per pump; one complete spare pump per station
DosingPeristaltic tube set, check valve, injector seals, foot strainer, spare dosing headOne tube set per dosing channel, replaced on schedule rather than on failure
SensingpH probe, EC probe, DO cap, temperature probe, buffer and standard solutionsOne spare per 10 installed probes, minimum one each
FiltrationScreen or disc elements, sand media top-up, cartridge set, O-ringsOne full change of elements per filter
DisinfectionUV lamp, quartz sleeve, O-ring set, ballast; ozone generator service kitOne lamp set per UV unit, replaced annually on a schedule
AerationBlower filter, belt or coupling, diffuser membrane set, non-return valveOne filter set plus one diffuser set
Valves and actuatorsSolenoid coils, diaphragms, actuator, manual override handleOne coil per ten valves, one actuator type per size
ClimateScreen and vent motor, limit switches, fan belt, bearingsOne motor per drive type
Electrical and controlsContactors, relays, fuses, power supply module, network switch, sensor cableAssorted set; standardise component models to shrink the list
ConsumablesNet pots, plugs, grommets, end caps, channel clips, sanitiser, cleaning acidOne crop cycle of forward cover

Setting Stock Levels Without Guesswork

Boxes of tomato trellis hooks and twine kept as crop workwear consumables

The Annual Maintenance Calendar

FrequencyTasksWindow
DailyAlarm review, EC/pH verification, filter differential pressure, visual leak and root checkIn-shift
WeeklyEmitter output test, injector verification, sensor buffer check, screen and vent function testIn-shift
MonthlyFilter cleaning or backwash system, tank inspection, UV sleeve check, drain line flush, backup power testHalf day
QuarterlyPump alignment and seal inspection, blower filter and belt, full calibration, electrical terminal check, structural fixings inspectionOne day, zone by zone
AnnualFull system dump and sanitise, gutter re-levelling survey, tank cleaning, pump overhaul, glazing and screen inspection, insulation checkPlanned shutdown, usually the crop change window

Sequence the annual shutdown into the crop calendar rather than the maintenance calendar. The cheapest week to stop production is the week you were changing crop anyway. Where a farm runs continuous production, split the annual tasks across zones and accept a longer total elapsed time.

Budgeting Spares

PhaseIndicative annual budgetNotes
Commissioning spares (one-off)1–3% of equipment capitalCovers the defects and commissioning losses that always appear in year one
Years 1–31–2% of equipment capital per yearWarranty period; labour is usually the larger cost
Years 4–102–4% of equipment capital per yearPump overhauls, sensor replacement, membrane and lamp replacement cycles
Year 10+Plan refurbishment or replacementCompare overhaul cost against replacement and energy efficiency gains

Budget in the local currency of your equipment supply, and remember that the two costs that hurt are not parts, they are freight and downtime. Air-freighting a control board costs several times the part; losing a third of a crop costs more than the whole spares budget for a decade.

Ten Things That Go Wrong

FAQ

How much should a hydroponic farm budget for spare parts?

Budget 1–3% of equipment capital for commissioning spares, then 1–2% per year during the warranty period and 2–4% per year from year four onward. Sites with long import lead times or poor local availability should sit at the top of those ranges.

Which spare parts are genuinely essential?

Anything whose failure stops irrigation within hours: circulation pump or its seal and bearing kit, blower, dosing pump, controller and main solenoid valves. Add pH and EC probes and UV lamp sets, which are scheduled consumables rather than optional stock.

Should I keep a complete spare pump?

For each pump station that has no installed redundancy, yes. Where you have duty-standby configuration, a seal and bearing kit per pump plus one spare motor is usually sufficient.

How do I set reorder points for consumables?

Multiply weekly consumption by lead time in weeks and add safety stock sized to one lead-time delay. Review quarterly, because consumption changes as the crop plan changes.

What belongs in an annual shutdown?

Full system dump and sanitisation, gutter re-levelling survey, tank cleaning, pump overhaul, glazing and screen inspection, insulation check, and a full recalibration. Schedule it in the crop change window so production loss is minimal.

How do I stop spares going missing?

Name an owner, lock the store, tag every item with part number and equipment ID, and require a work order to remove anything. Log the failure that consumed each part — that log is what justifies next year’s budget.

Get a Spares List Matched to Your Installation

Send your equipment list, system layout and import lead times through the quote form. We will return a criticality-ranked spares schedule with quantities, a stocking policy, and a consolidated shipment that travels with your equipment order.
